Aurora Estate Stage 2 Construction

Latest updates

Status: Construction Commenced

  • During the month of October, the contractor will predominantly be undertaking bulk earthworks, including some deep sewer pipe installation.
  • Earthworks roster:
    • Residents are advised that the Contractor has requested to work a continuous roster until 1 November 2026. This allows them to finish the earthworks, which is expected to create the most noise and dust, as quickly as possible.
    • Council has agreed to this because working without breaks almost halves the time the earthworks take, and with it the period of noise, dust and truck traffic. We know this busy period will be disruptive, and we are very grateful for your patience. Council’s view is getting the hardest part of the work done quickly is the best way we can reduce the longer-term impacts to residents.
  • Fill material hauling:
    • Fill material for the development will be transported from Old Chinaman’s Pit located at the Charleville Airport to the Aurora Estate.
    • Hauling of fill material will commence from 6 October 2026.
    • Residents can expect high volumes of truck movements across the Warrego Highway.
    • There will be speed reductions along the Warrego Highway during hauling of fill material. Residents are requested to take care traveling through this zone and observe all speed and warning signs.

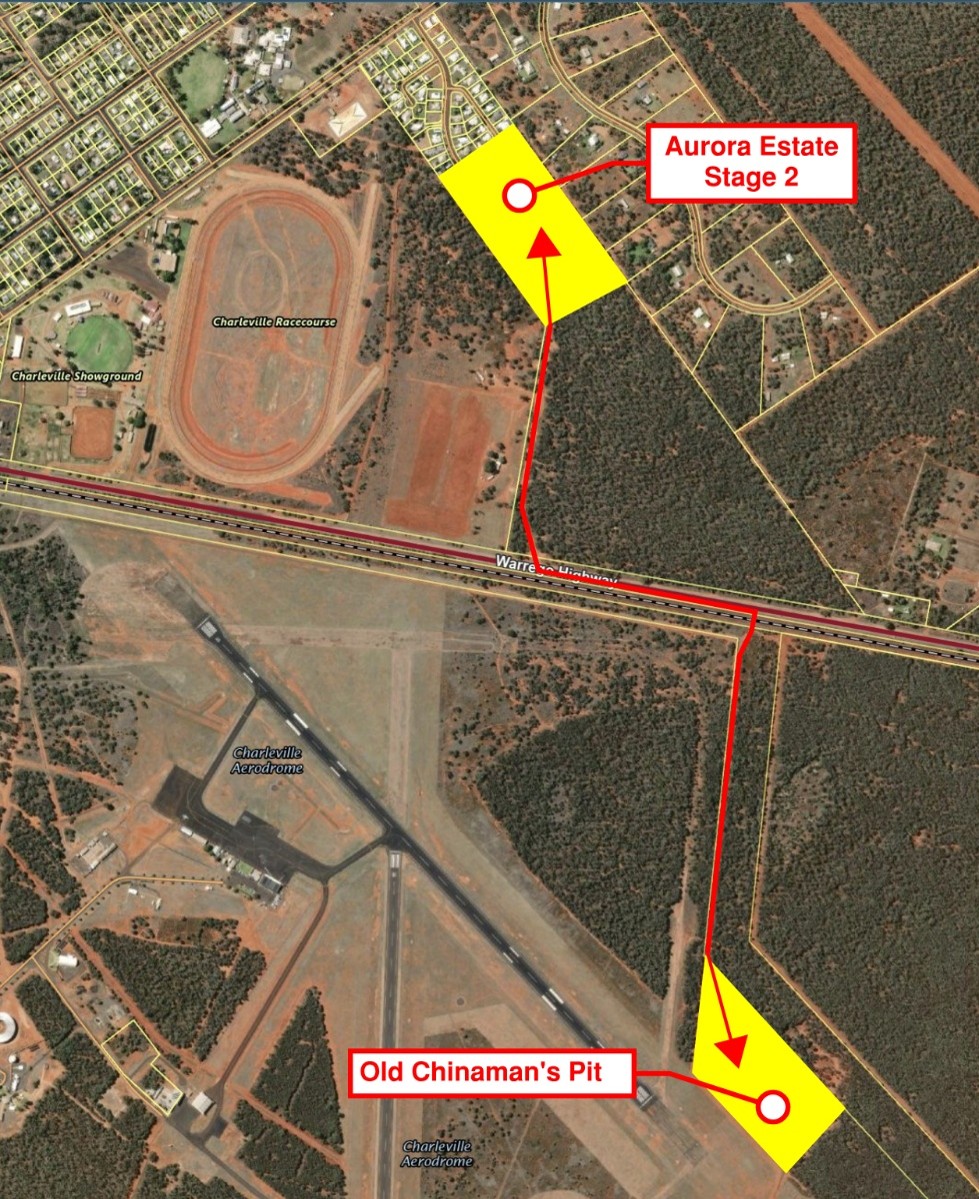

    • The haul route is illustrated below:
  • The Contractor’s roster is provided below, detailing when the crews are expected to be on site, and when they will be on a break:

#

Status

From

To

1

Contractor On Site

21/09/26

01/11/26

–

Contractor on Break 1

02/11/26

09/11/26

2

Contractor On Site

10/11/26

22/11/26

–

Contractor on Break 2

23/11/26

30/11/26

3

Contractor On Site

01/12/26

13/12/26

–

Contractor on Break 3

14/12/26

21/12/26

–

Xmas Shut Down

22/12/26

03/01/27

4

Contractor On Site

04/01/27

17/01/27

–

Contractor on Break 4

18/01/27

27/01/27

5

Contractor On Site

28/01/27

07/02/27

–

Contractor on Break 5

08/02/27

15/02/27

6

Contractor On Site

16/02/27

28/02/27

–

Contractor on Break 6

01/03/27

08/03/27

7

Contractor On Site

09/03/27

21/03/27

–

Contractor on Break 7

22/03/27

29/03/27

8

Contractor On Site

30/03/27

11/04/27

–

Contractor on Break 8

12/04/27

19/04/27

9

Contractor On Site

20/04/27

02/05/27

–

Contractor on Break 9

03/05/27

10/05/27

10

Contractor On Site

11/05/27

23/05/27

–

Contractor on Break 10

24/05/27

31/05/27

11

Contractor On Site

01/06/27

13/06/27

–

Contractor on Break 11

14/06/27

21/06/27

12

Contractor On Site (demobilise)

22/06/27

04/07/27



Further updates will be provided on a monthly basis

Project Overview:

Murweh Shire Council is creating 65 new flood-free residential lots at the southern end of Racecourse Drive, extending the Aurora Estate.

Every lot will be fully serviced — town water, sewerage, stormwater, underground power and telecommunications, sealed roads and footpaths. Lot sizes range from 839 to 1,904 square metres, and two parkland areas will be set aside for the community.

These additional 65 flood free residential lots will enable the building of new houses for the people in our community desperately needing housing, and those people providing essential medical, teaching, emergency and social services in our community.

At a glance

New Residential Lots       65, all flood-free
 Lot sizes  839 m2  to 1,902m2
 Location Southern end of Racecourse Drive and High Street, Charleville
Site Area 8.8 hectares
Also includes 2 parkland area and a new sewerage pump station
Expected completion Mid 2027
Funded by Proudly funded by the Queensland Government in association with Murweh Shire Council



aurora Estate Stage 2.jpg



Frequently asked questions

When will lots be available to buy?

To be confirmed — Council has not yet set the sales process or timing.

How much will the lots cost to buy?

To be confirmed — Council has not yet confirmed sales pricing.

How do I register my interest?

Interested buyers are welcome to register via the contact details in the section below to be kept informed of the sales process.

Will local residents be given priority to purchasing lots?

At this stage Council does not intend to give preference to any buyer, rather encourage an open procurement process that affords the opportunity and welcomes local residents and residents abroad to move to the estate.

Is there a limit on how many lots one person or company can purchase?

At this stage there is planned to be no limit on how many lots one person or company can purchase. However, should one person or company wish to purchase more than one lot, Council will review the proposal in the interests of the community and benefits to the region.

What are the building conditions proposed for the estate?

Council is currently drafting a covenant and will make this available at a suitable time.

Who is building it?

The contractor is Durack Civil.

Will the works affect my property or access?

The works are inside the development site. You will notice more construction traffic, and some noise and dust during earthworks. We will give advance notice of any key impacts.

The contractor will be required to undertake dust suppression.

Some impacts will be experienced by residents that border the Stage 2 works where a retaining wall has been designed. These residents will be contacted directly to discuss timing and impacts.

What are the construction working hours?

The contractor will work on a 14 days on / 7 days off non-continuous roster arrangement.

The construction working hours are as follows:

Weekdays:

  • Days: Monday to Friday (inclusive)
  • Hours: 6:00 am to 6:00 pm.

Weekends:

  • Days: Saturday to Sunday (inclusive)
  • Hours: 8:00 am to 5:00 pm.

Council may extend construction working hours where necessary to deliver critical works.

How will construction traffic be managed?

All construction traffic is required to enter the construction site via the Warrego Highway. No construction traffic is permitted through Aurora Estate Stage 1 without Council approval.

Are the lots flood-free?

Yes. All 65 lots will be flood-free.

What services will be connected?

Town water, sewerage, stormwater drainage, and underground power and telecommunications. Each lot fronts a sealed road.

Who do I contact?

See contact details below if you have any questions.

Project Documentation

Please find below links to project documentation:

Contact us

Questions or concerns about the Aurora Estate project? Please contact Council on the details below.
